History

Tracing the timeline of lindane, from pesticide to contaminant that required one of the most complex remediation processes.

Text by Goran Mijuk, photos from Novartis and other archives

scroll-down
Home
en
de
zh
jp
Share
Share icon
content-image
Enter fullscreen

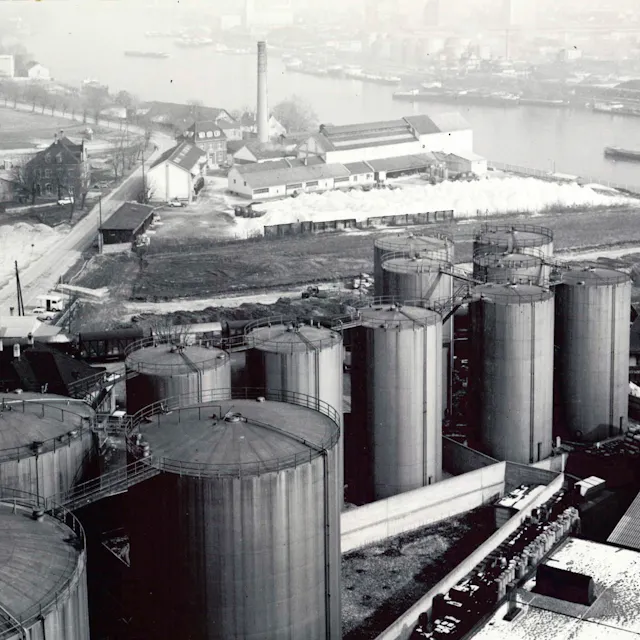

View of the Ugine Kuhlmann production site in Huningue.

Published on 01/07/2021

1947

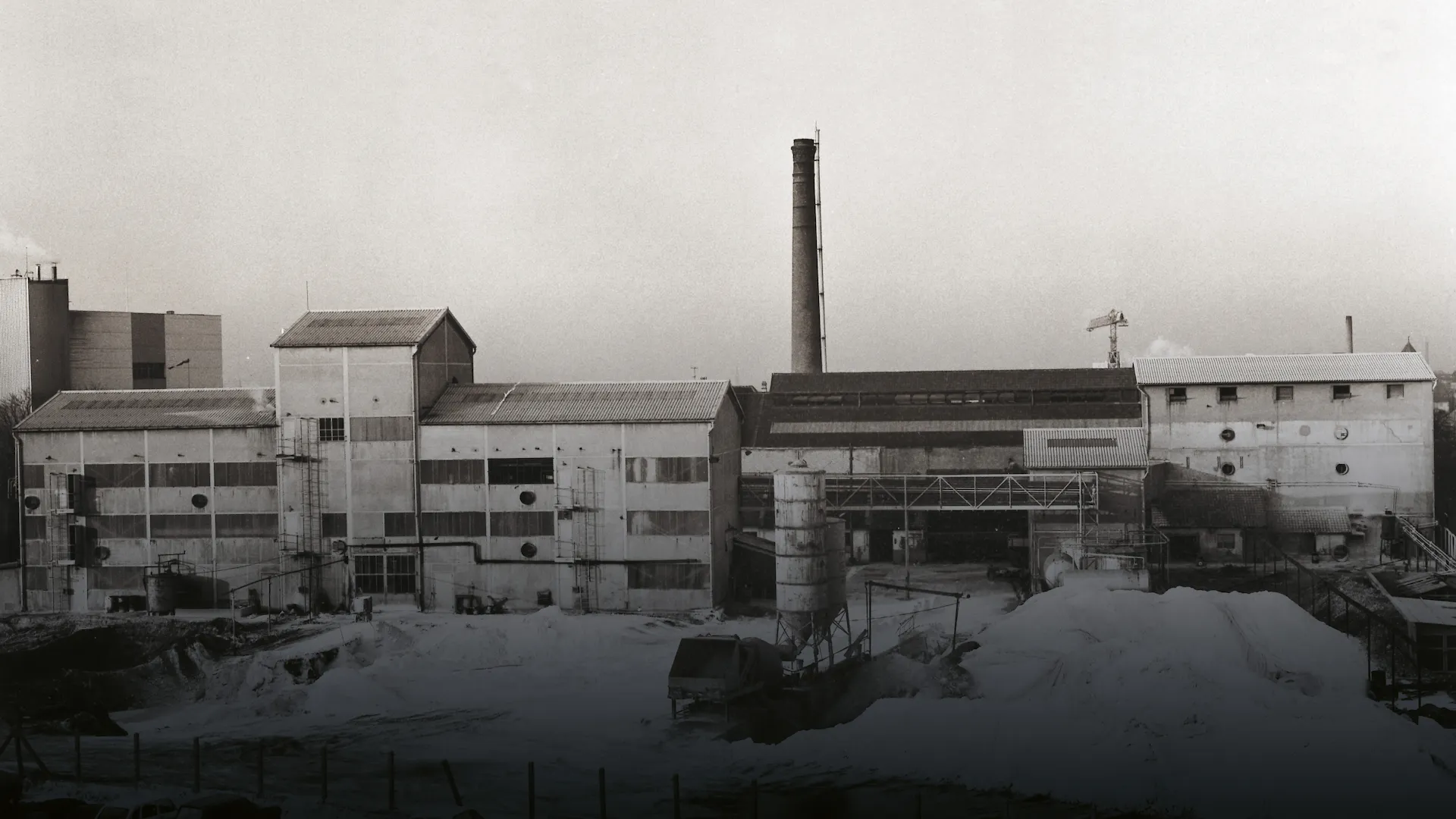

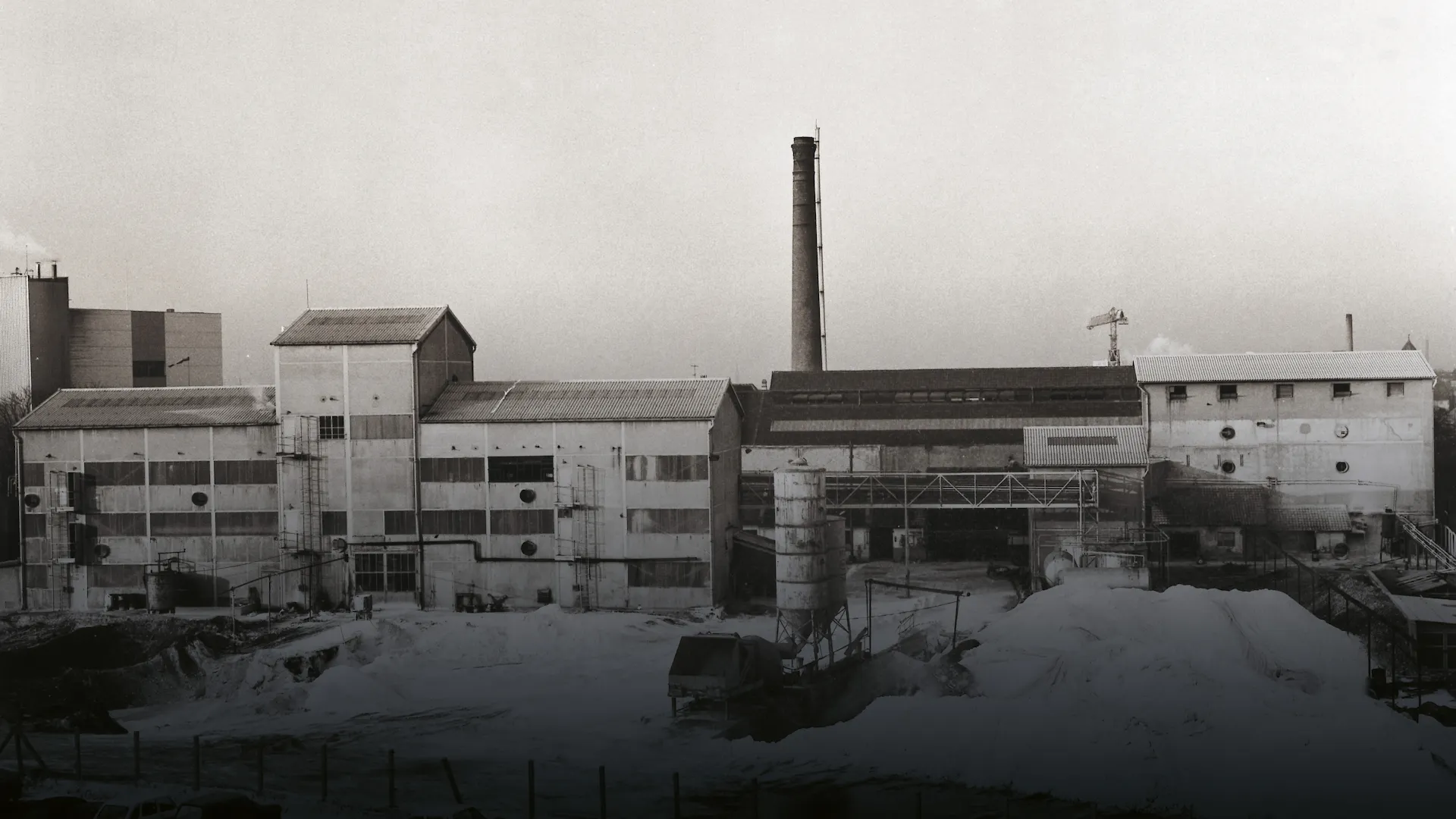

Produits Chimiques Ugine Kuhlmann (PCUK) commences production of lindane, hexachlorocyclohexane (HCH).

1950s

“Hexa-potatoes” effect noted by the “Journal of Agricultural Research and others”, leading to a production change creating more HCH waste.

1973

Sandoz acquires the site.

1974

Ugine Kuhlmann stops production of lindane. A 2,500-square meter pit with a depth of 4 meters is excavated on the site to dump HCH waste, which is covered by a layer of asphalt and later serves as a parking lot. Groundwater monitoring starts.

1976

The former Ugine Kuhlmann plant is demolished.

1978

Construction begins on the industrial wastewater treatment plant (STEIH). During construction, extensive amounts of soil are moved and used as backfill across the site, dispersing HCH-contaminated soil.

1981

Industrial wastewater treatment is put into operation.

1992

A hydrological and hydrochemical study is carried out by the Bureau de recherches géologiques et minières (BRGM).

1994, 1995

Additional investigations are conducted by the Antea consultancy to locate the sources of the contaminated groundwater.

February 1996

A report from the Regional Directorate for Industry, Research and the Environment (Direction régionale de l’industrie, de la recherche et de l’environnement, DRIRE) highlighting groundwater pollution is sent to the Prefect of the Upper Rhine.

June 1996

The Prefect of the Upper Rhine issues an order stating that the existence of residual deposits of HCH waste is likely to damage the soil and subsoil and that Ugine Kuhlmann must be considered responsible for the pollution.

September 1996

As ordered by the administration, the wastewater treatment operator submits a report describing the means of containment of the HCH pit.

December 23, 1996

Ugine Kuhlmann goes into liquidation.

March 25, 1997

An order is issued to the liquidator of Ugine Kuhlmann to carry out containment work at the Huningue site.

1999 and 2000

The Prefect of the Upper Rhine requests funds from the French Environment and Energy Management Agency (Agence de l’environnement et de la maîtrise de l’énergie, ADEME) to ensure the groundwater is monitored for a period of two years.

End of 2002

Sandoz executes repair work on the parking lot located directly above the HCH pit.

July 2008

The Prefect of the Upper Rhine orders groundwater monitoring to continue until February 2013.

September 2011

Additional site investigations are carried out on behalf of Novartis to determine the extent of the contamination.

February 2012

Novartis informs the French authorities that the wastewater treatment operation will stop at the end of 2012. The untreated wastewater will be diverted to the modernized ProRheno treatment plant in Basel.

December 2012

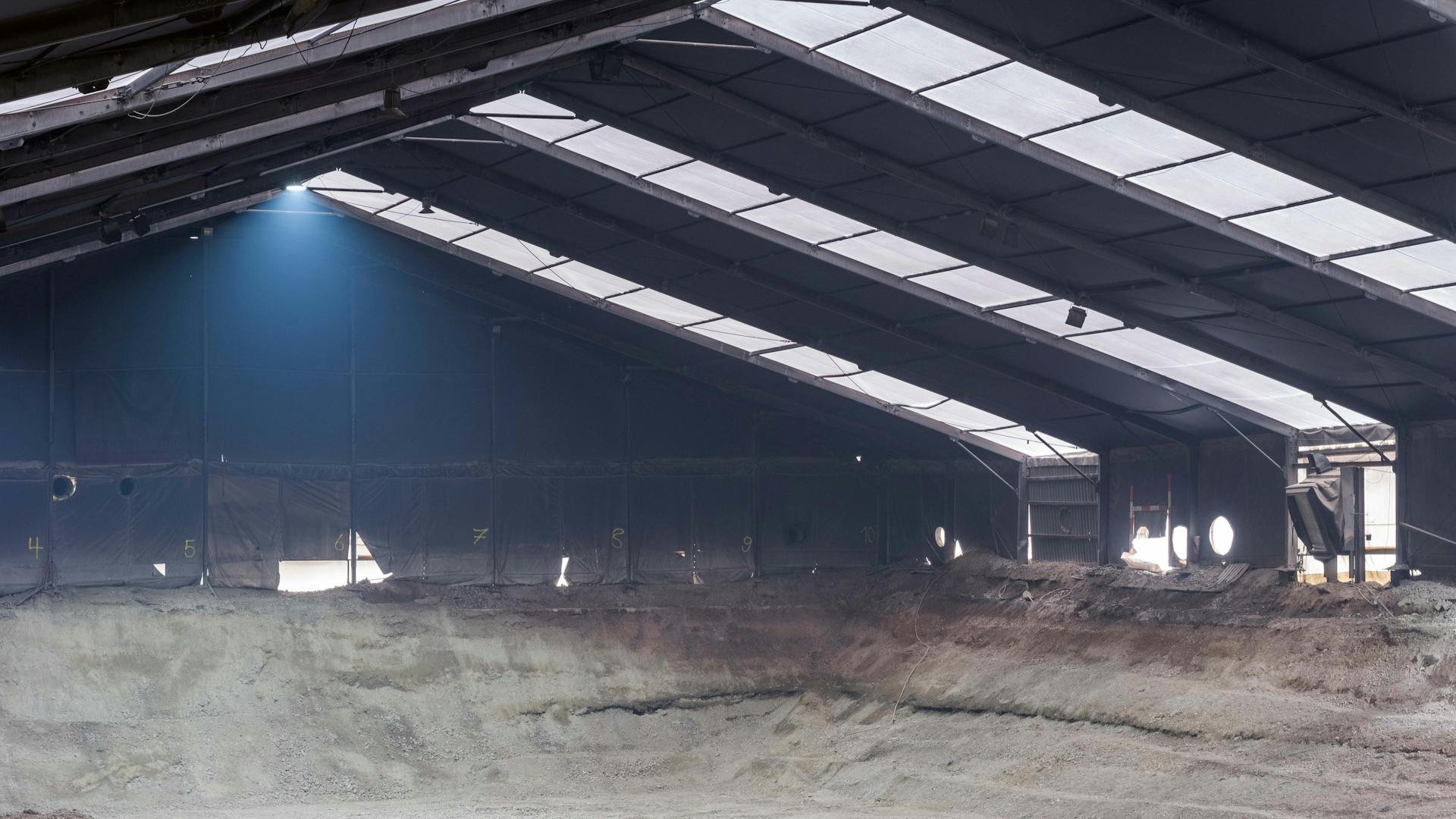

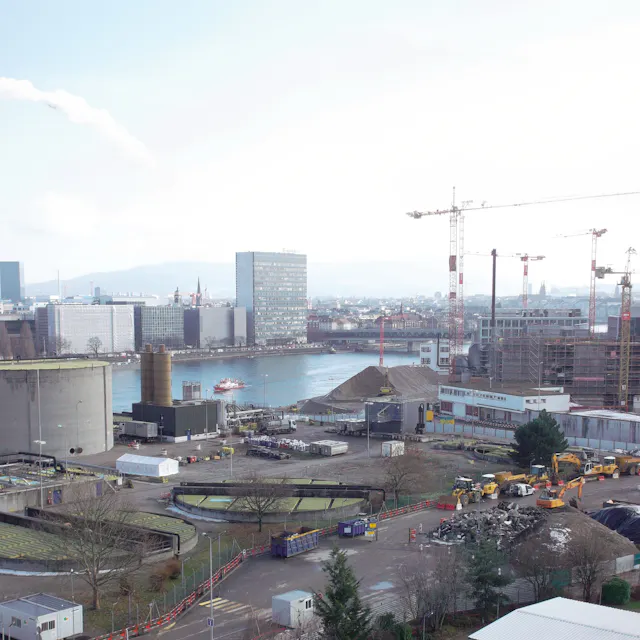

Shutdown of the industrial water treatment plant; dismantling and remediation of the Rhine banks and the main site commences. Original project timeline was to have the remediation work completed in December 2013.

June 2013

First odor complaint received from the Basel Klybeck area.

September 24, 2013

Remediation work is temporarily suspended due to dust containing HCH being spread from the remediation site to neighboring areas.

October 2014

Risk analysis and reinforcement of the project in terms of:

technology (infrastructure and remediation process);

monitoring of the atmosphere, water and soil;

proactivity in terms of communication;

collaboration with the French and Swiss authorities; and legal and financial support.

The analysis also leads to changing service providers. A test phase (proof of concept) is initiated in order to reduce residual uncertainties.

May 2015

Remediation work is resumed. Restart of remediation activities approved by the steering committee.

March 2016

Diploma thesis by Stefan Brendel (ERM) on “The CO2 Balance of the ARA STEIH Remediation Site”

2018

Transport of contaminated materials slows due to the low water level of the Rhine.

October 2019

Soil remediation completed, confirmed by DREAL on October 24, 2019.
